How long does it take to remodel a bathroom?

Bathroom mid-remodel at the waterproofing stage, with green membrane sealing the shower walls, a sloped shower pan set, and large-format wall tile going up with spacers and a level

Television is the enemy of realistic expectations here. A thirty minute episode compresses weeks of mechanical work, inspections, and tile setting into a montage, and homeowners arrive at their first consultation genuinely surprised that a shower cannot be built in a weekend.

The honest answer is that a bathroom takes longer than almost anyone expects, and most of that time is not people swinging hammers. It is design, permitting, material lead times, and the unglamorous waiting that good waterproofing and tile work require. Here is the real schedule, phase by phase.

Quick takeActive construction runs about 2 to 3 weeks for a powder room, 4 to 6 weeks for a full hall or guest bath, and 6 to 10 or more weeks for a custom primary suite or wet room. Once you add design, material lead times, and permitting, the full end-to-end process typically runs 2 to 5 months.

Timeline by bathroom type

Scope drives schedule far more than square footage does. A large bathroom with fixtures staying put moves faster than a small one where everything relocates.

Bathroom typeScope of workActive constructionTotal end to end
Powder room or half bathFixture update, vanity swap, new tile floor2 to 3 weeksAbout 1.5 to 2.5 months
Guest or hall bathroomFull gut, standard tub or shower alcove, plumbing updates4 to 6 weeksAbout 2.5 to 3.5 months
Primary suite or wet roomStructural changes, curbless shower, custom millwork6 to 10+ weeksAbout 4 to 6 months
Active construction time by bathroom type A bar chart. A powder room takes about 2 to 3 weeks of construction, a guest or hall bathroom 4 to 6 weeks, and a primary suite or wet room 6 to 10 or more weeks. ACTIVE CONSTRUCTION (WEEKS) 2 4 6 8 10 Powder room 2 to 3 wk Guest / hall bath 4 to 6 wk Primary / wet room 6 to 10+ wk Construction only. Add design, ordering, and permitting for the full timeline.
Construction is only part of it. The full project runs considerably longer.

Phase by phase

Phase 1: design, engineering, and permitting (4 to 8 weeks)

Nothing gets demolished during this phase, which is exactly why people underestimate it. This is as-built measuring, space planning, selecting every fixture and finish, and submitting for the plumbing, mechanical, and electrical permits your scope requires.

Selections happen here on purpose. They set both the budget and the lead times, and a single undecided tile can hold up an entire schedule. Permit fees typically run about 0.5 to 1.5 percent of project cost. Our current lead time to start a new project is roughly one month, which is the window used for finalizing design, ordering, and permits.

Phase 2: demolition and framing (week 1)

Tear-out to the studs, then the most important inspection of the project: what the walls and subfloor actually look like. Old showers hide moisture damage, and this is when you find it. Framing follows, including niche cutouts, a bench if you are building one, and the sloped structure for a curbless shower.

Phase 3: rough mechanicals (week 2)

Plumbers move supply and waste lines and set the shower valve. Electricians run GFCI circuits and the exhaust fan. Then everything stops for city rough inspections, which must pass before anything gets covered. Schedule inspection days as fixed points, because a failed or delayed inspection stalls every trade behind it.

Phase 4: waterproofing (week 3)

Cement backer board goes up, then the waterproofing membrane, sheet or liquid applied, that forms the sealed tank behind your tile. A shower pan flood test follows, holding water for roughly 24 hours to prove the assembly does not leak.

That flood test is a full day where nothing else happens in that bathroom, and it is not optional. Anyone offering to skip it to save a day is offering you a future demolition.

Phase 5: tile, countertops, and millwork (weeks 4 to 6)

Floor and wall tile go in, then grout, then the vanity and countertop. Tile is the phase most sensitive to detail: large-format tile and intricate patterns take longer to set, and thinset and grout each need cure time between steps. This is skilled work that cannot be compressed without showing.

Phase 6: trim-out, glass, and punch list (weeks 6 to 8)

Toilets, faucets, showerheads, lighting, mirrors, paint touch-up, then final inspection and a walkthrough punch list. And the frameless glass, which deserves its own warning below.

Bathroom remodel construction phases in sequence A sequential bar chart of construction phases: demolition and framing in week one, rough mechanicals in week two, waterproofing and flood test in week three, tile and countertops in weeks four to six, and trim out with glass and punch list in weeks six to eight. Glass fabrication cannot begin until tile is complete. CONSTRUCTION SEQUENCE wk 1 wk 2 wk 3 wk 4 to 6 wk 6 to 8 DEMO + FRAMING ROUGH MECHANICALS inspection WATERPROOFING 24 hr flood test TILE + COUNTERTOPS TRIM-OUT + GLASS glass measured only after tile
Each phase depends on the one before it, which is why a single delay moves everything.

Three things that add weeks

Hidden moisture damage. The most common schedule breaker. Pull an old tiled shower and you frequently find a rotted subfloor, damaged framing, or a leak that has been quietly working for years. It must be repaired before anything is rebuilt. Carry a contingency in both your budget and your calendar.

Long-lead materials. Custom vanities, specialty thermostatic valves, and imported tile can run 8 to 12 weeks from order to delivery. This is why selections belong in the design phase, not week two of construction. A vanity that ships in week nine of a six week project is not a delay, it is a redesign.

Frameless glass fabrication. The one nearly everyone forgets. Frameless shower glass cannot be measured until tile is completely finished, because it is templated to your actual walls, which are never perfectly plumb. Fabrication then takes around two weeks. So even with everything else done, there is a stretch near the end where the bathroom is beautiful and you still cannot use the shower.

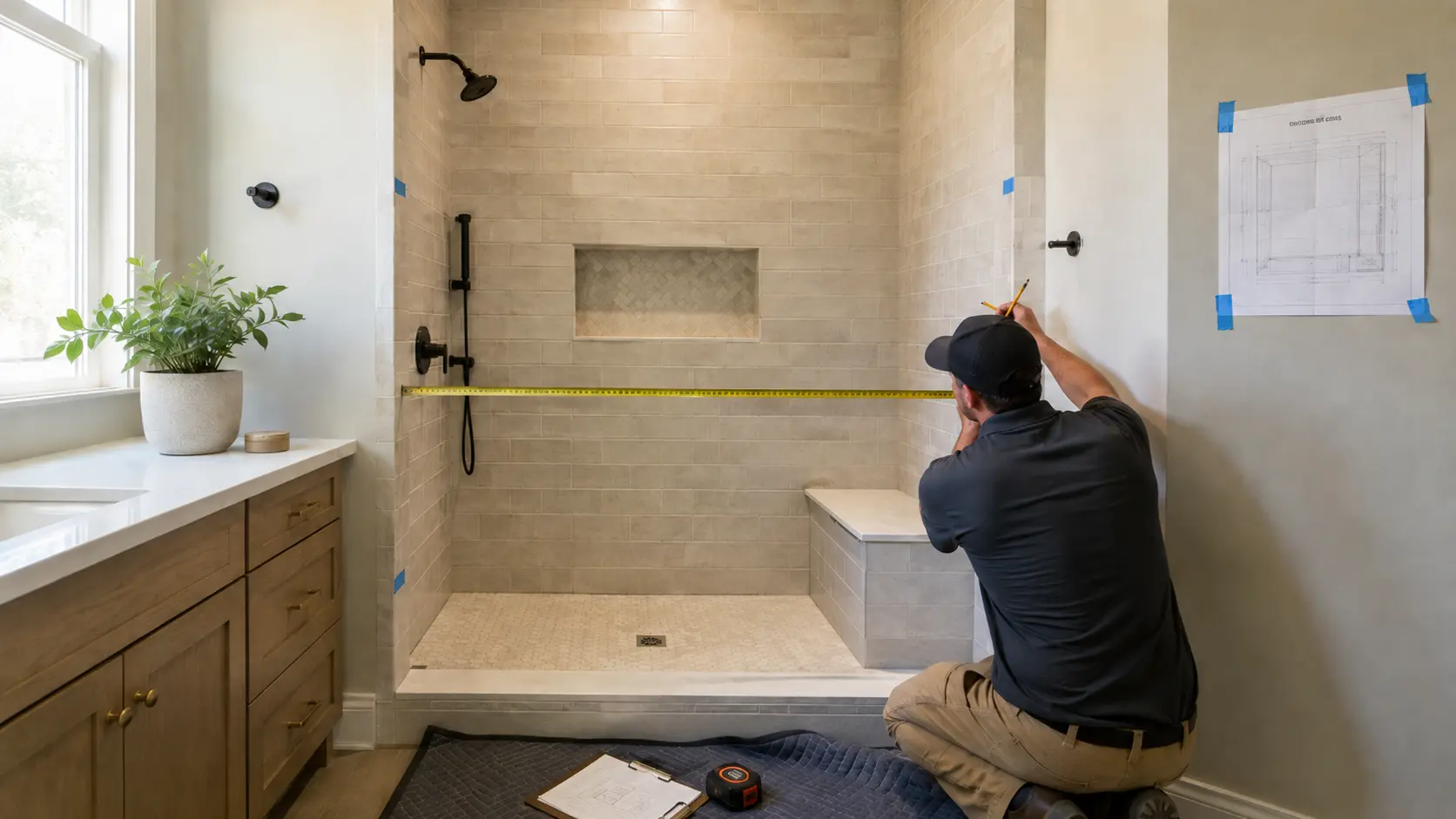

Finished tile shower awaiting frameless glass templating and fabrication
Glass is templated only after tile is complete.

How a design-build process protects the schedule

Most bathroom delays are logistical, not technical, which means they are preventable.

Materials arrive before demolition. Every fixture, tile, and vanity is ordered during design and delivered to storage before day one. A crew never stands in a gutted bathroom waiting for a box, and lead times overlap the design and permit window instead of following it.

Trades are sequenced without gaps. Plumber, electrician, inspector, waterproofer, tile setter, glazier, painter. When one contract covers design and construction, those hand-offs are scheduled in advance rather than negotiated as each phase ends. Gap days between trades are where two week projects quietly become five week projects.

Inspections are planned as fixed dates. Rough inspection and final inspection are scheduled around, not discovered.

You can see how we structure this on our how it works page, and browse our approach to bathroom remodeling.

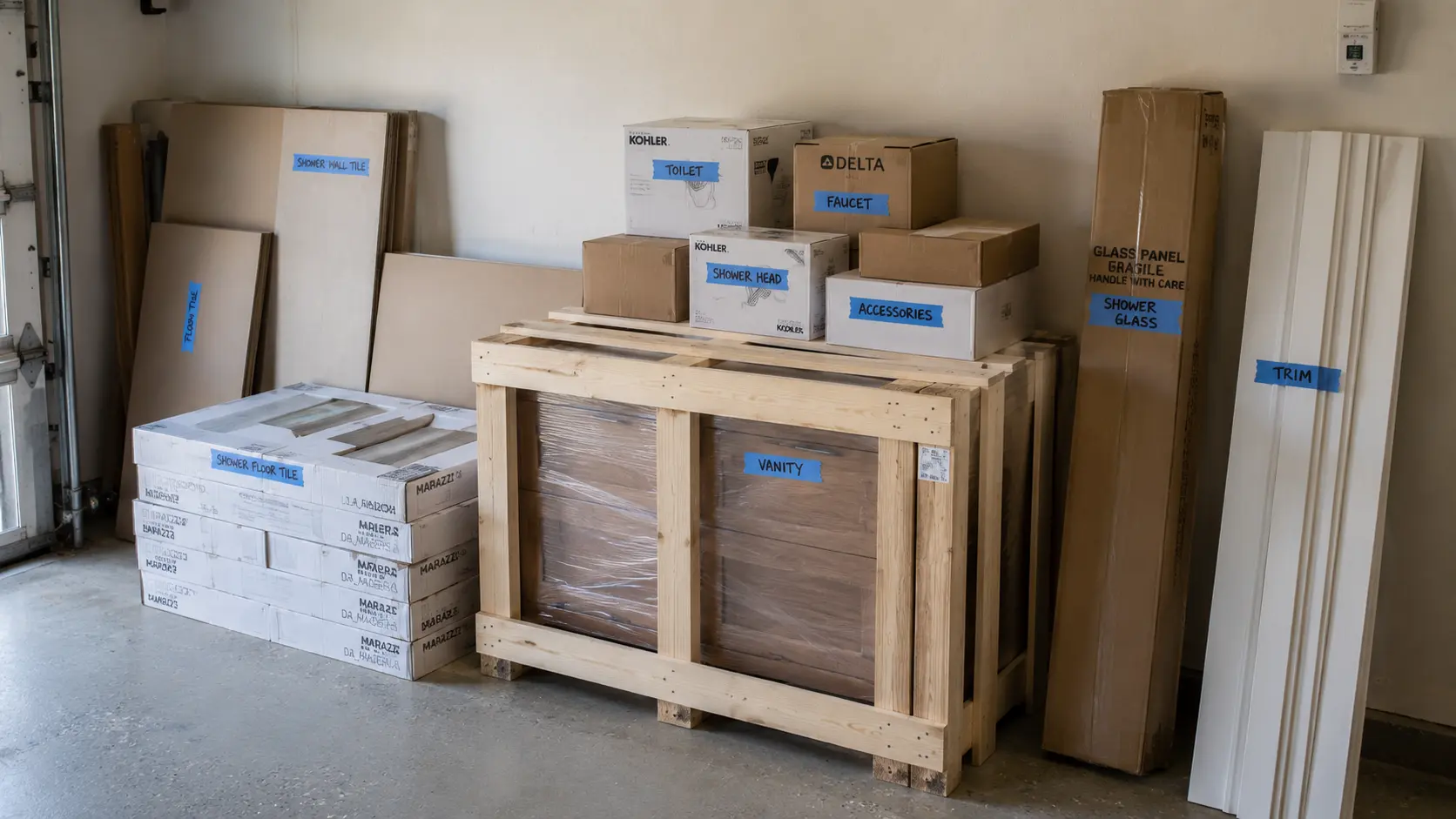

Tile, vanity, and fixtures staged in storage before bathroom demolition begins
Ordering during design is what keeps construction moving.

FAQ

Frequently asked questions

How long does a bathroom remodel take?

Active construction runs about 2 to 3 weeks for a powder room, 4 to 6 weeks for a full guest or hall bathroom, and 6 to 10 or more weeks for a custom primary suite. Including design, material ordering, and permitting, the full end-to-end process typically takes 2 to 5 months.

Why does a bathroom remodel take so long?

Because the phases are sequential and several involve mandatory waiting. Rough mechanicals must pass city inspection before walls close, waterproofing includes a roughly 24 hour shower pan flood test, thinset and grout need cure time, and frameless glass cannot be measured until tile is finished, then takes about two weeks to fabricate.

How long does the design and permitting phase take?

Usually 4 to 8 weeks, covering measuring, space planning, fixture and finish selections, and submitting for plumbing, mechanical, and electrical permits. Selections drive both budget and lead times, so this phase moves at the speed of your decisions.

Can you use the bathroom during the remodel?

No, not the one being remodeled. Plan on losing that bathroom for the entire construction period. If it is the only full bathroom in the house, arrange alternatives before demolition, because there is no partial-use stage.

What causes bathroom remodel delays?

Three things account for most of them: hidden moisture or rot found after demolition, long-lead materials such as custom vanities and imported tile that can take 8 to 12 weeks, and frameless glass fabrication near the end. Ordering during design and carrying a contingency prevents most of the impact.

Ready to start your bathroom transformation?

A realistic bathroom timeline is not bad news. It is the difference between a project that finishes when you were told it would and one that drifts for months while you shower at the gym. The schedule is knowable, as long as selections are made early, materials are ordered before demolition, and inspections are planned rather than discovered.

Back to all articles
